How to Estimate the Cost of a Mold or Die

How to Estimate the Cost of a Mold or Die

A tooling quotation is a forecast of hours and purchases for a product that does not exist yet. Estimate too low and the job loses money; too high and it goes to a competitor. Buyers face the mirror image: without knowing how a price is built, they cannot tell a realistic offer from one that will lead to delays and claims. This article gives a structured method that works for injection molds, die-casting dies, stamping dies and extrusion tooling, with a worked example.

The structure of a tooling price

Every tool price can be built from five cost blocks, followed by overhead and margin.

Block Contents Basis
1. Design and programming Feasibility review, tool design, drawings, simulation, CAM programming Hours × hourly rate
2. Materials and bought-in parts Tool steel, mold base or die set, standard parts, hot runner, cylinders, springs Supplier prices plus cutting and delivery
3. Machining Milling, turning, grinding, wire and sinker EDM, drilling of cooling Hours per machine group × machine hourly rate
4. Heat treatment, coating and bench work Subcontracted treatments; fitting, spotting, polishing, texturing, assembly Subcontract prices; hours × rate
5. Trials and corrections Machine time, material, measuring, correction loops, sample shipment Number of trials × cost per trial, plus an allowance for corrections

Then add:

  • Overhead and risk that are not already inside the hourly rates;
  • Margin;
  • Delivery and commercial costs: packing, freight, insurance, financing of the payment terms, sales commission.

Step 1: Fix the scope

Most estimating errors are scope errors. Before counting hours, write down:

Item Why it matters
Part drawing or model revision, and open design points Later part changes are extra work and should be priced as such
Number of cavities; family or single-part tool Drives size, machining and balance
Expected tool life and annual volume Decides steel, hardness and construction class
Part material Wear, corrosion, shrinkage, hot runner type
Surface requirements: polish level, texture Polishing can exceed machining hours on cosmetic parts
Tolerances that need special measures Extra trials and corrections
Machine data: tonnage, platen, shut height, automation Tool size and interfaces
What the price includes Trials, sample quantity, measurement report, spare parts, texture, shipping terms

Step 2: Outline the tool concept

A price cannot be estimated from the part alone. Sketch the concept: parting line, number of slides or lifters, gating, ejection, number of stations for a progressive die, number of plates. From it, list the main components and their sizes. Each moving element is a cost item in every block: design, steel, machining, fitting.

Element Typical effect on the estimate
Each slide or lifter Adds design, several machined parts, fitting and trial risk
Hot runner A large bought-in item plus wiring and extra plates
Deep ribs and sharp internal corners Electrodes and sinker EDM hours
High-polish surfaces Bench hours and better steel
Each progressive station Punches, inserts, wire EDM hours
Interchangeable inserts or versions Extra parts and fitting

Step 3: Estimate materials

Calculate steel by block size, not by finished size: add machining allowance and saw cuts. Weight in kg = length × width × height in mm × 7.85 ÷ 1,000,000. Price each grade separately, and ask for current quotations for the mold base, hot runner and other large bought-in items. Add 5–10 % for small standard parts that are not individually listed.

Step 4: Estimate hours

Use two methods and compare them.

Bottom-up. List the main components and estimate hours per operation for each: roughing, heat treatment allowance, finishing, EDM, wire, grinding, drilling. Count electrodes: each one needs design, machining and burning time.

Top-down. Compare with completed jobs of similar size and complexity, using the actual recorded hours, not the hours that were quoted. A simple record of actual hours per finished tool, by block, is the most valuable estimating aid a shop can keep.

If the two results differ by more than about 20 %, find out why before quoting.

Step 5: Apply the rates

Machine hourly rates should cover depreciation, floor space, energy, maintenance, tooling and consumables, and the operator, at the realistic utilization of each machine group. A five-axis machining centre and a manual mill do not have the same rate. Using one average shop rate hides where the money goes and distorts every estimate.

Worked example

A two-cavity injection mold with two slides, cold runner, pre-hardened mold base and hardened cavity inserts. Amounts are in neutral currency units.

Block Detail Amount
Design and programming 80 h × 25 2,000
Materials and bought-in parts Mold base 3,500; insert and slide steel 1,200; standard parts 900 5,600
Machining CNC milling 160 h × 30 = 4,800; sinker EDM 60 h × 25 = 1,500; wire EDM 20 h × 25 = 500; grinding 25 h × 20 = 500 7,300
Heat treatment and coating Subcontract 600
Fitting, polishing, assembly 110 h × 18 1,980
Trials and corrections 2 trials × 450 900
Direct cost 18,380
Overhead and risk 10 % 1,838
Margin 12 % of 20,218 2,426
Quoted price 22,644

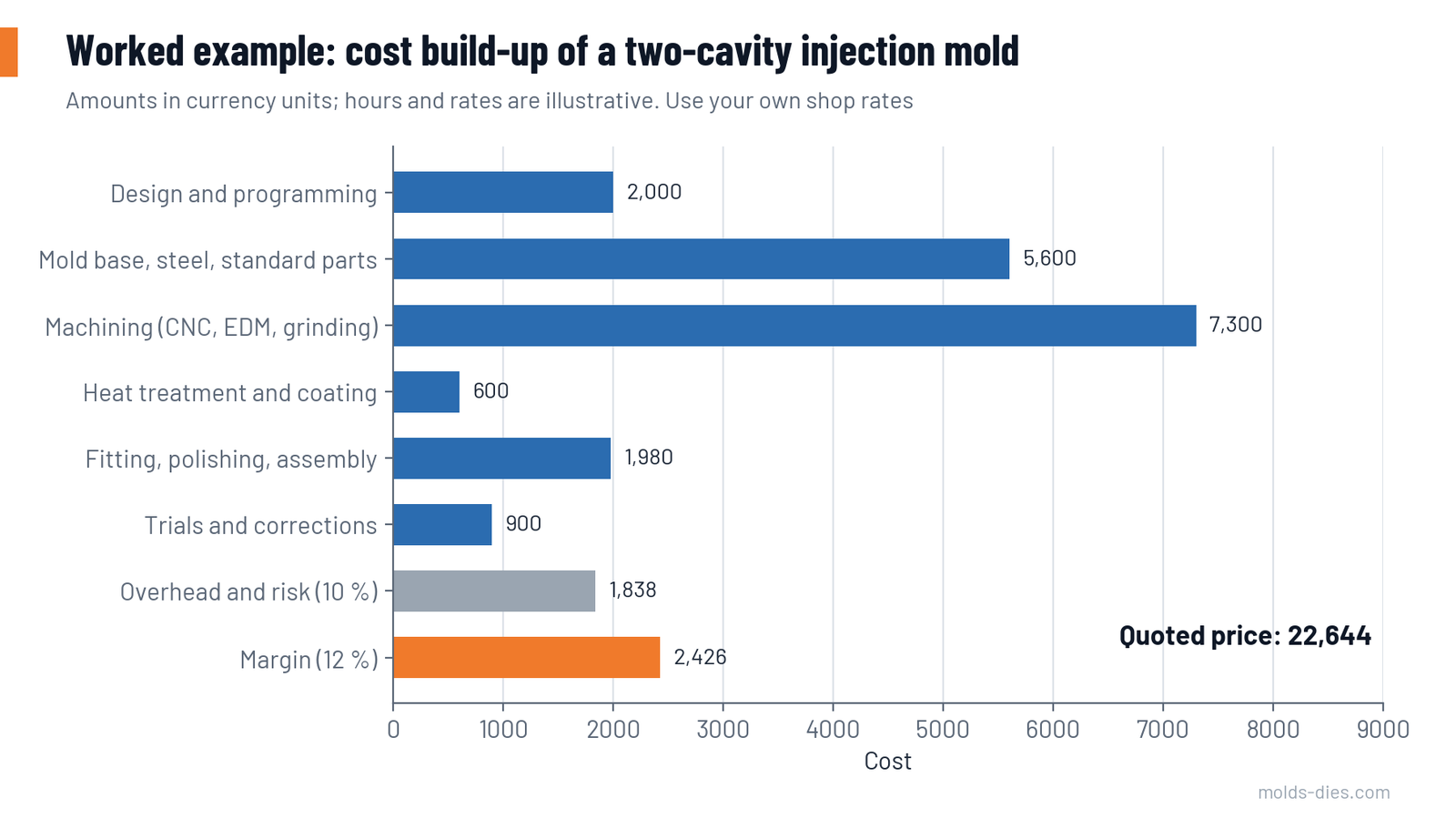

Cost build-up of the example mold by block, with overhead and margin
Cost build-up of the example mold by block, with overhead and margin

Step 6: Check the result

Check Typical range If outside
Materials and bought-in parts as a share of price 20–35 % without a hot runner; more with one Hours or materials are probably wrong
Machining as a share of price 30–45 % Review the concept and the electrode count
Design as a share of price 8–15 % Complex tools sit at the upper end
Bench work 8–15 %; 20 % or more for high-polish tools Check polishing assumptions
Price compared with similar past tools, adjusted for size and features Within about 15 % Look for a missed feature or a wrong assumption

Risk and margin

Add a specific allowance for each real risk, not one general percentage:

  • part design not frozen;
  • tight tolerances on long dimensions in a material with uncertain shrinkage;
  • new material, new customer, or a tool type the shop has not built before;
  • cosmetic requirements judged by eye;
  • penalties for late delivery.

Risk and margin together typically fall between 10 and 20 % of the price. Also price the payment terms: a tool paid 30 % with order and 70 % ninety days after approval ties up money for months.

For buyers: reading a quotation

Ask every supplier for the same breakdown: steel grades and hardness, mold base standard, hot runner make, number of cavities, lead time to first samples, number of trials included, guarantee of tool life, and terms. Then compare.

Signal in a quotation What it may mean
Much lower than the others with the same lead time Lower steel grade, fewer hardened parts, no allowance for corrections
No steel grades stated Open to substitution
Very short lead time Parallel subcontracting; less control of quality
Trials "as needed" without a number Later dispute about who pays
No mention of part changes Every change becomes a negotiation

Common mistakes

Mistake Consequence
Quoting from the part without a tool concept Slides, lifters and electrodes forgotten
Finished sizes instead of block sizes for steel Material 15–30 % too low
Underestimating polishing and fitting Bench work overruns
No allowance for correction loops Margin spent on the second trial
One average hourly rate Complex tools underpriced, simple ones overpriced
Never comparing quoted and actual hours The same errors repeat

Key takeaways

  • Build the price from five blocks: design, materials, machining, treatment and bench work, trials; then add overhead, risk and margin.
  • Fix the scope and sketch the tool concept before estimating; each moving element adds cost in every block.
  • Estimate hours bottom-up and check them against actual hours of similar past tools.
  • Use sanity ratios to catch errors, and price specific risks and payment terms explicitly.
